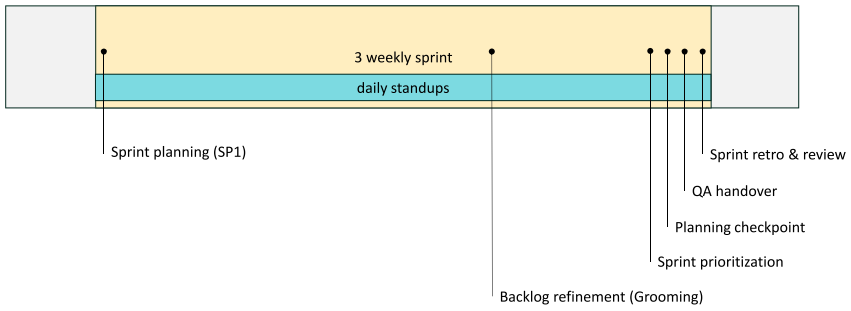

3 Week Sprint Cadence

Dev Sprint Breakdown

- Day 1 : Start of sprint - SP1 - committing to dev work for the coming sprint
- Day 1 to 10 : Committed stories being developed and completed - INCLUDING testing
- Day 11 to 15 : Regression week with whole team involved in testing. Developers fix regression bugs found
- Day 15 : Sprint reviews
Definition of Done
- Code Reviewed
- Dev tested
- No open Bugs
- PO Approved
- Ready to be deployed to QA
- Languageable
- Unit of Measure aware
- Asset site timezone aware

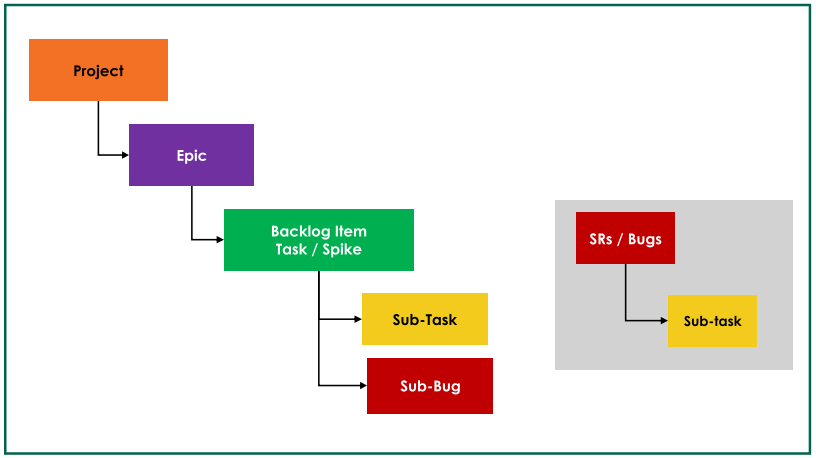

Jira Work Items Hierarchy

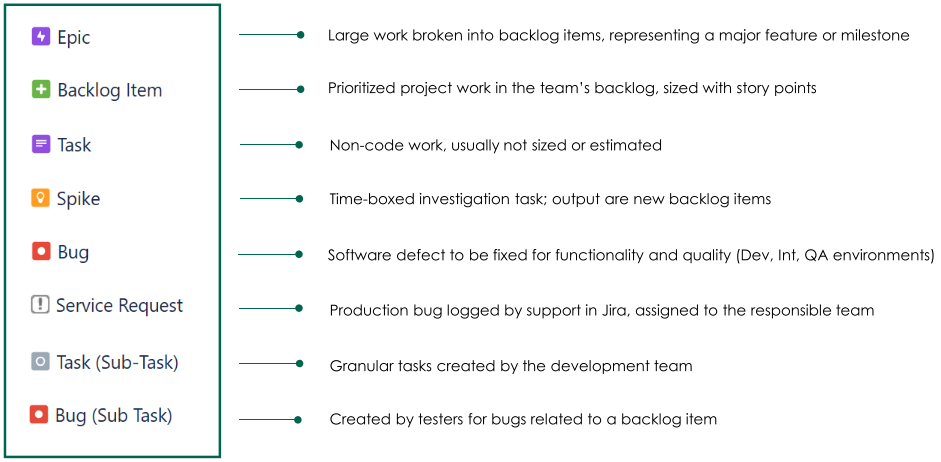

Work Item Types (Issue Types)

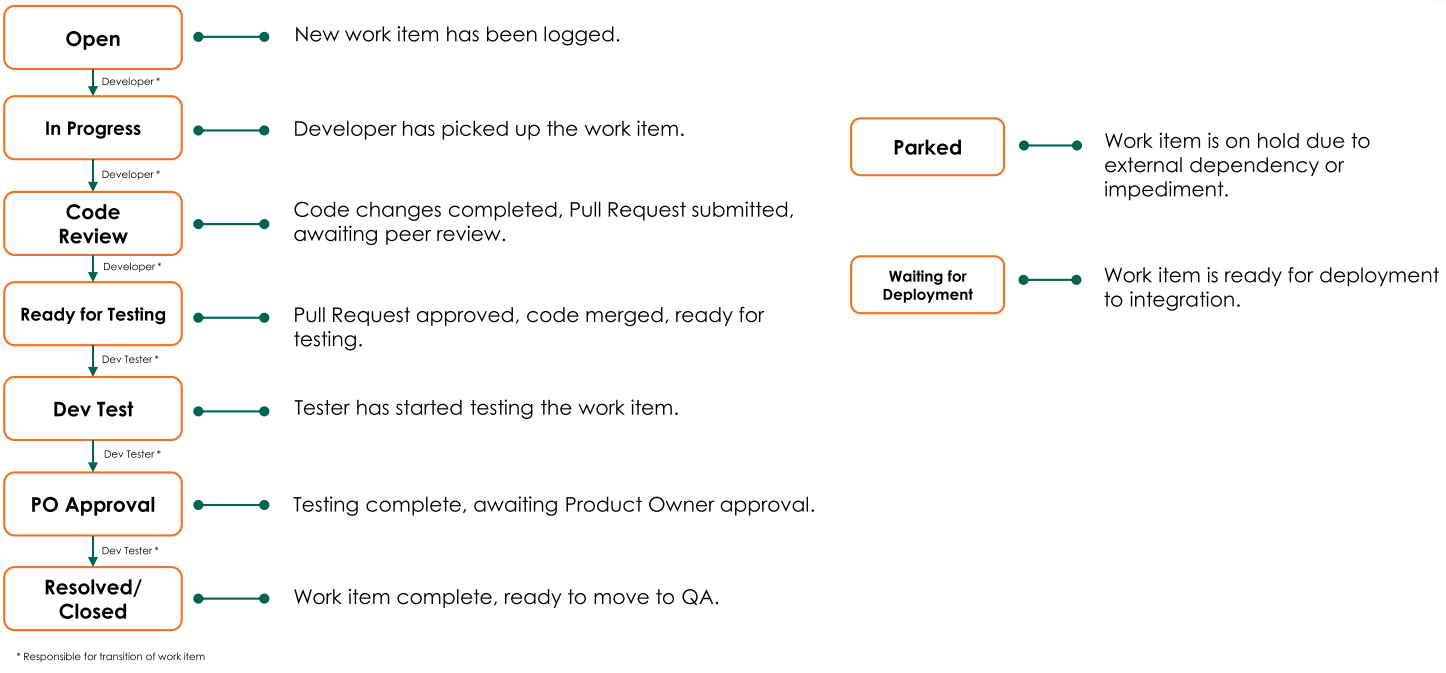

Workflow (Backlog Item)

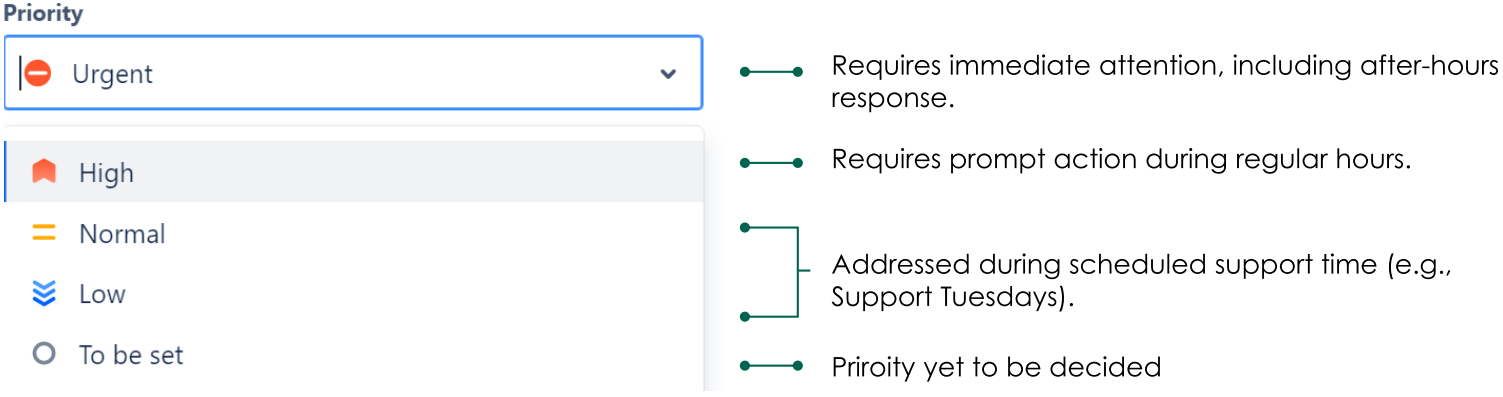

Prioritization of QA bugs and SRs

Only set by Support on Service Requests (SRs) and on QA Bugs.
Exception: Dev bugs that block testing can be set to “blocker” with an explanatory comment.
Priority of the backlog items is set by their position in the backlog

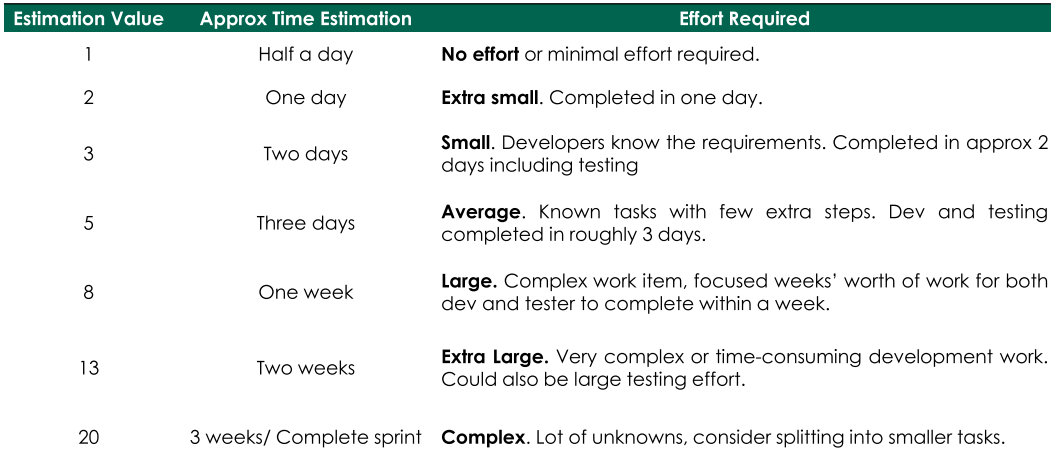

Estimation

IMPORTANT: Estimations to always include dev testing effort
This is only a guide. The Story points are less important than the conversations it invokes

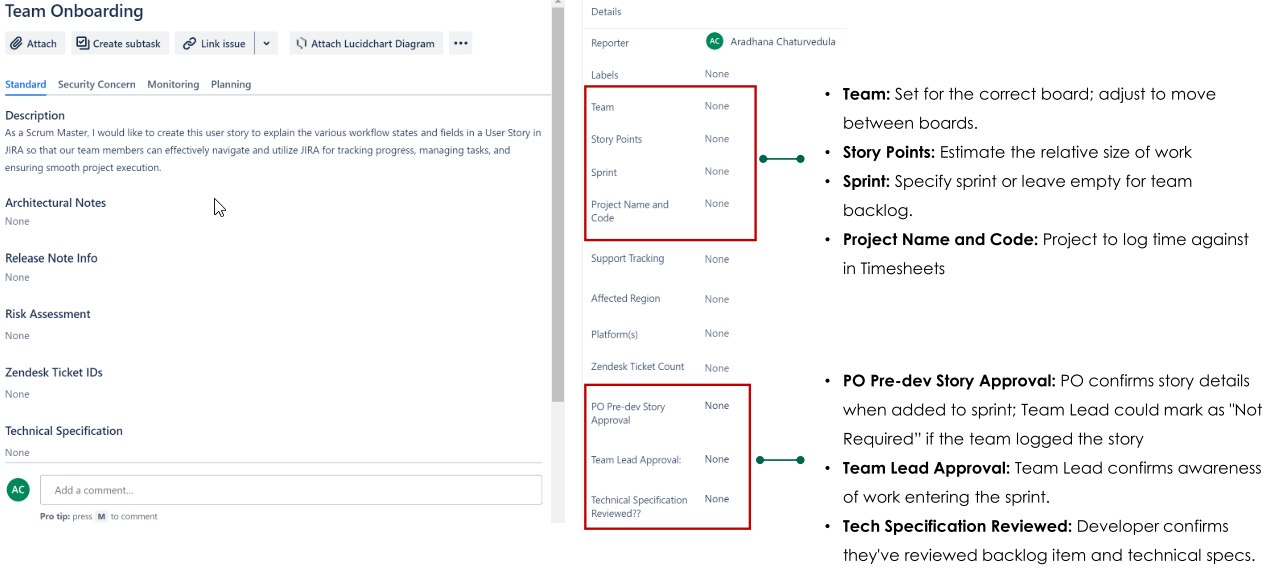

Important fields

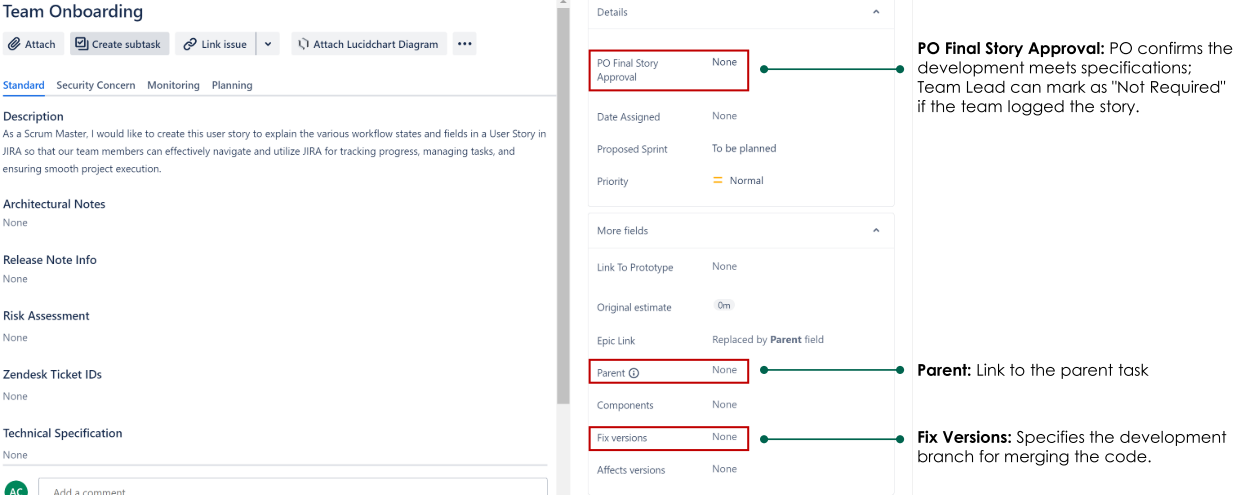

These fields are required to move a backlog item from Open to In-Progress

These fields are important to close the work item
